AI Automation for Finance Teams: Where to Start

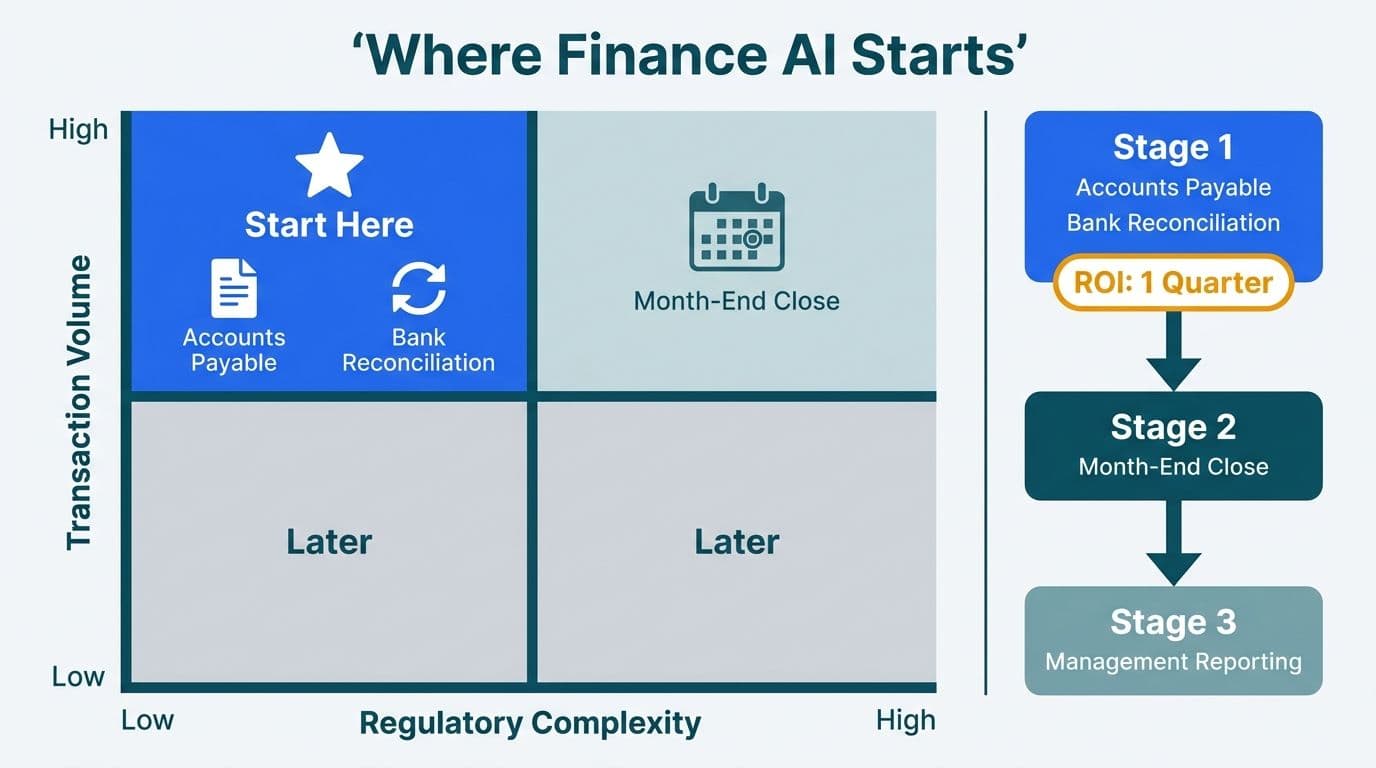

Priority matrix placing accounts payable in the high-volume, low-complexity start-here quadrant, beside a three-stage finance AI rollout roadmap
By Neetu Singla6 min read

For finance teams asking where to start with AI automation, the answer is clear: begin with the process that combines high transaction volume with low regulatory complexity. Accounts payable and bank reconciliation meet both criteria for most mid-market organizations - rules-driven, repetitive, and audit-trail-friendly. Month-end close and management reporting follow once data infrastructure is stable. Starting here delivers measurable ROI within one quarter while building the CFO confidence needed for broader rollout.

Key Takeaways

  • Accounts payable and bank reconciliation are the highest-priority first targets - high ROI, manageable implementation risk.
  • Month-end close automation requires clean, governed source data; automating a disorganized close makes errors faster, not fewer.
  • Management reporting is the highest-value outcome but depends on a stable semantic data model - automate it last.
  • Compliance obligations (SOC 2 and HIPAA for US healthcare, GDPR for UK/EU, PIPEDA for Canada) must drive tool selection before a single workflow is built.
  • Agents must verify financial outcomes, not just task status - unverified automation creates audit exposure rather than efficiency.

Where Should Finance Teams Start with AI Automation?

Five-step accounts payable automation pipeline from invoice received through AI extraction, three-way match, and payment posting

Most finance automation initiatives fail not because the technology underperforms, but because teams attempt to automate processes that are not ready. An AI agent applied to a disorganized general ledger produces disorganized outputs faster. A structured prioritization framework forces two questions before any tool is selected: what is the ROI potential of automating this process, and what is the implementation risk given current data quality, headcount, and compliance requirements?

This article applies both lenses to the four processes most commonly targeted by CFOs and finance directors at mid-market firms: bank reconciliation, accounts payable, month-end close, and management reporting. The framework draws from practical AI automation consulting work with finance teams across the US, UK, and Canada.

ROI in this context has two dimensions: time saved per cycle and error reduction rate. A process running daily that demands eight hours of analyst effort delivers more automation value than a quarterly task requiring two hours, even if the quarterly task feels more painful.

Implementation risk is shaped by three factors: source data quality, regulatory sensitivity of the data, and the number of systems the automation must touch. More systems and more regulated data equals higher risk.

Which Finance Process Should You Automate First?

For most mid-market organizations, bank reconciliation is the highest-priority Wave 1 target. It scores highest on ROI and lowest on implementation risk across the four-process framework.

ProcessROI PotentialImplementation RiskRecommended Wave
Bank ReconciliationHighLowWave 1
Accounts PayableHighMediumWave 1
Month-End CloseHighMedium-HighWave 2
Management ReportingVery HighHighWave 3

Bank reconciliation is deterministic: match transactions against bank statements, flag exceptions, escalate anomalies. Inputs are structured (ERP exports or bank API feeds), the logic is rules-based, and the output is binary - matched or unmatched. An AI matching layer handles the bulk; analysts review the exception queue. The human role shifts from executing reconciliations to resolving edge cases.

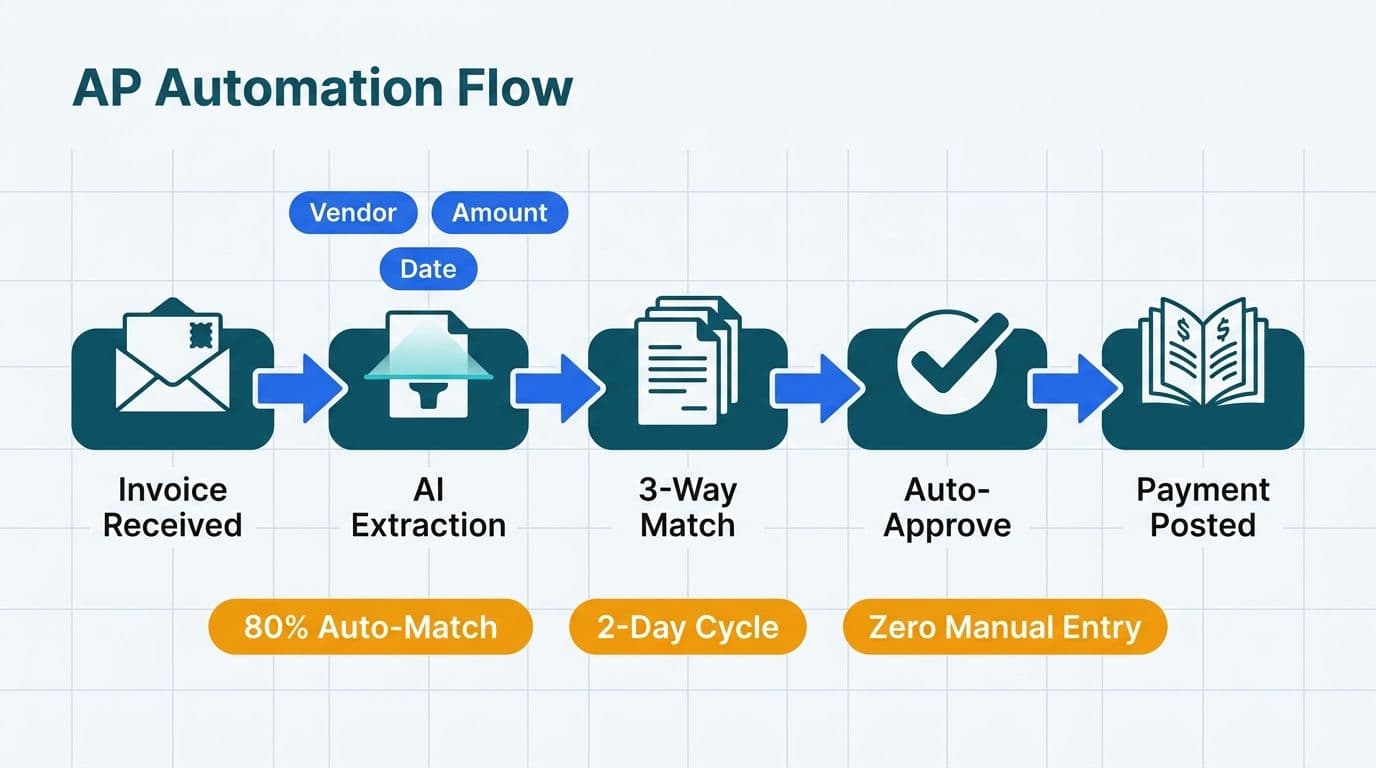

Accounts payable sits alongside reconciliation in Wave 1 because the core workflow - receive invoice, extract data, match to purchase order, route for approval, schedule payment - is similarly structured. AI document processing handles invoice ingestion; a workflow engine manages routing and approval. Our AI automation for accounts payable guide covers this workflow step by step.

How Do You Automate Month-End Financial Close with AI Tools?

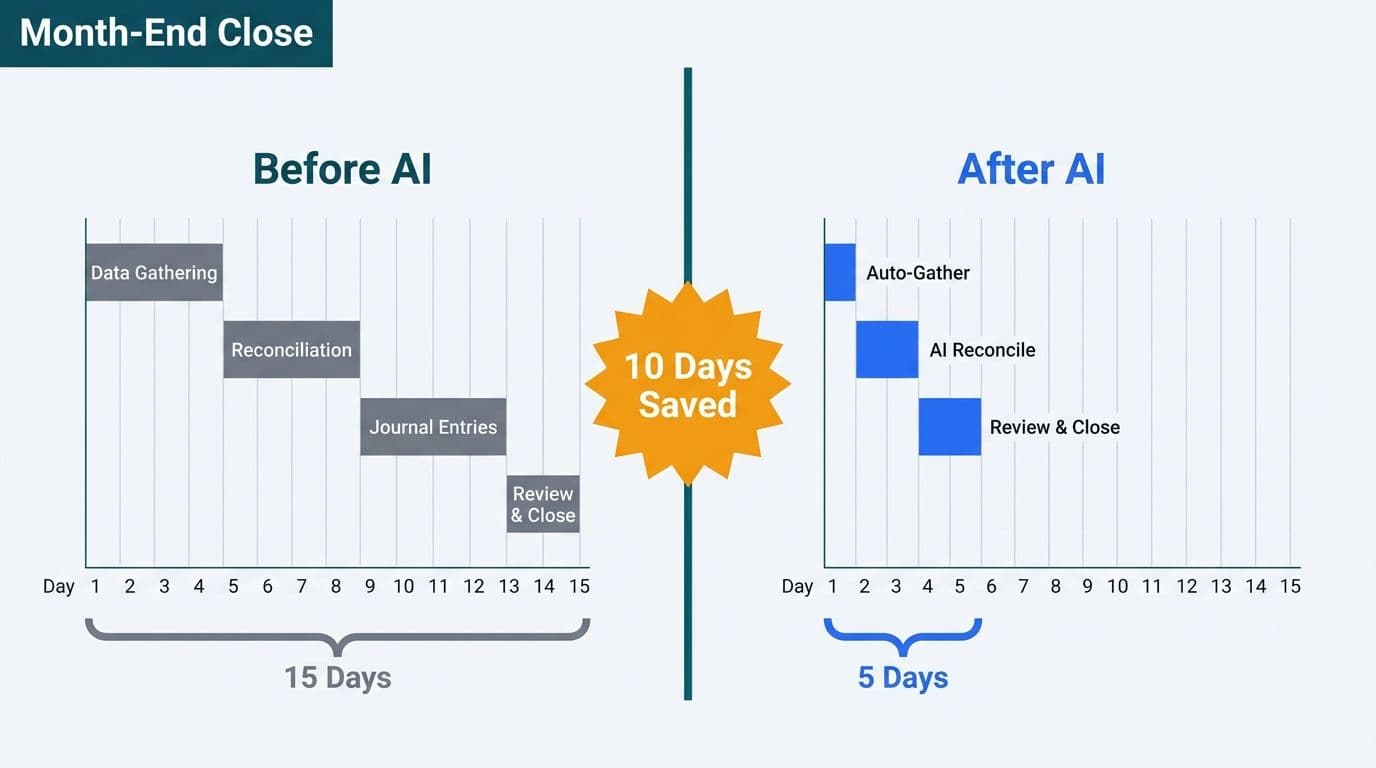

Gantt chart comparing 15-day manual month-end close against a 5-day AI-automated close, highlighting 10 days saved

Month-end close is the most emotionally charged automation target - and the most frequently mishandled. The problem is rarely the tooling. Month-end close is not a single process; it is a sequence of 20 to 40 discrete tasks (journal entries, accruals, reconciliations, consolidations, variance analysis) that depend on each other in a defined order, running on data that is often late or unclean at period-end.

The correct approach to automate month-end financial close with AI tools is to decompose the close checklist into its constituent tasks, rank each by dependency depth and data readiness score, and automate the highest-volume, lowest-dependency tasks first.

In practice, that means three starting points:

  • Automated journal entry preparation: recurring entries (depreciation, prepaid amortization, accruals with known amounts) can be drafted by an AI agent pulling from ERP data, then held for CFO sign-off before posting. Nothing auto-posts without human approval.
  • Exception-driven variance analysis: instead of an analyst authoring variance commentary from scratch, an AI agent queries actuals versus budget, identifies movements above threshold, drafts the narrative, and routes it for review. The analyst edits, not authors.
  • Intercompany reconciliation: for multi-entity organizations, AI can match intercompany payables and receivables across entities, flag mismatches, and prepare the reconciliation summary for controller sign-off.

A UK fintech firm running a five-entity close benefits most from intercompany reconciliation automation first - but must ensure any AI tool processing personal financial data is deployed within EU/UK data residency boundaries under GDPR before the workflow is built. Tool selection precedes workflow design, not the other way around.

A Canadian manufacturing company subject to PIPEDA must verify that any AI vendor processing personal financial data is covered by contractual privacy safeguards, and that cross-border data flows to US-hosted AI APIs carry an established legal basis before the workflow goes live.

How Do You Prioritize AI Automation by ROI and Implementation Risk?

Running the framework against your own finance function requires five honest internal steps.

Step 1 - Map your task calendar. List every finance task by frequency (daily, weekly, monthly, quarterly), average hours per cycle, and headcount involved. This produces your raw ROI surface before any technology is considered.

Step 2 - Score data readiness. For each task, rate source data quality on a 1-5 scale. Score 1 means analysts spend significant time cleaning data before the task can begin; score 5 means data arrives clean and structured. Any task scoring below 3 is not automation-ready - you will automate the mess and accelerate errors rather than eliminate them.

Step 3 - Score regulatory sensitivity. US healthcare finance teams must account for HIPAA when patient billing or claims data touches any AI processing layer. SOC 2 Type II requirements mean audit trails and access controls must be designed in from the start, not retrofitted. Assign a risk multiplier: low for general ledger tasks, medium for AP and AR, high for payroll, patient billing, or claims processing.

Step 4 - Calculate the adjusted ROI score. Multiply time saved per cycle by annual frequency, then divide by the risk multiplier. The highest-scoring processes in this calculation are your Wave 1 targets.

Step 5 - Select your orchestration layer. When evaluating n8n vs OpenAI Agent Builder for finance automation, the decision typically comes down to data residency requirements and logic complexity. n8n is an open-source workflow orchestrator that runs on your own infrastructure - the right choice for teams with on-premise ERPs or strict data residency requirements under GDPR or PIPEDA. OpenAI's Agent Builder excels at natural language tasks (variance commentary, exception summaries) but requires financial data to pass through external API endpoints, which needs legal review for regulated industries. In practice, many enterprise finance teams use both in combination: n8n for workflow orchestration and a language model API for AI-generated narrative content.

What Does AI Management Reporting Automation Actually Require?

Management reporting is Wave 3 because it delivers the highest business value and carries the highest infrastructure dependency. An AI-generated management pack is only as accurate as the governed data layer underneath it.

The architecture has three sequential layers:

1. Data layer: a governed semantic model in Power BI, Microsoft Fabric, or Looker Studio that defines metrics consistently across departments. Without this foundation, AI-generated reports surface inconsistent numbers across business units. The Fabric Lakehouse finance analytics architecture is one proven approach for FP&A reporting at scale in mid-market organizations.

2. AI narrative layer: a language model queries the semantic model, identifies key movements (revenue versus prior period, budget versus actual, working capital trends), and drafts the CFO narrative section and board commentary.

3. Review layer: the draft management pack is routed to the finance director for review, annotation, and approval before distribution.

A critical discipline applies across every layer: agents must verify financial outcomes, not just task completion status. In our own automation work, we once had 26 auto-generated performance tasks marked as resolved while the underlying issue remained completely unaddressed - resolved meant a human had acknowledged the recommendation, not that anything had been fixed in the system. In finance automation, this distinction is existential. An AP workflow that marks invoices as "processed" without confirming payment execution is not an efficiency gain - it is an audit liability. Build explicit outcome verification steps into every agent workflow before it touches live financial data.

How Do Compliance Obligations Shape Your Finance Automation Roadmap?

Compliance is not a blocker to finance automation - it is a design input. Teams that treat it as an afterthought build automation they later have to redesign under regulatory pressure.

For US healthcare finance teams, HIPAA requires any AI tool processing patient billing or claims data to be covered by a Business Associate Agreement (BAA) with the AI vendor. Not every orchestration platform offers BAAs - verify before procurement. SOC 2 Type II audit requirements mean every automated financial transaction must carry an immutable log of what agent initiated it, when, and based on what input data.

For UK and EU finance teams, GDPR Article 22 limits fully automated decisions with significant financial effect on individuals - payment blocking, credit decisions - and requires human review or opt-out rights to be available. Build human-in-the-loop checkpoints into any AP or credit automation before considering whether to remove them.

For Canadian organizations under PIPEDA, any AI vendor processing personal financial data must be covered by a contractual privacy safeguard, and individuals must be able to request information about automated decisions that affect them.

Across all three jurisdictions, the practical instruction is the same: start Wave 1 with human approval on every output. Earn trust through demonstrated accuracy across a full business quarter before reducing review frequency.

Finance teams building or upgrading the data infrastructure that underpins AI reporting should review the Power BI governance best practices checklist, which covers the access control and audit trail requirements that support both compliance and AI readiness.

What Is a Realistic 12-Month Finance Automation Timeline?

A mid-market finance team of 10 to 20 people can work to the following phased schedule:

  • Months 1-2: Data readiness assessment, tool selection, compliance review. No automation is deployed yet. This phase prevents costly rework.
  • Months 3-4: Wave 1 deployed in parallel with existing manual processes. Bank reconciliation and AP automation run alongside human workflows; exception queues reviewed daily; accuracy benchmarked against manual outcomes.
  • Months 5-8: Wave 1 validated. Human review frequency reduced based on demonstrated accuracy. Month-end close decomposition begins. Recurring journal entry automation deployed for the close cycle.
  • Months 9-12: Full Wave 2 in production. Management reporting data layer governed and validated. Wave 3 architecture designed and vendor procurement begun.

This timeline assumes no concurrent ERP migration. If your team is mid-migration, pause Wave 2 planning until the new system is stable - automating against transitional data sources compounds risk and defers the expected cycle time reduction indefinitely.

For teams ready to scope their automation roadmap and identify data layer gaps before tool selection begins, the free BI readiness assessment is a structured starting point.

---

About Lets Viz: Lets Viz has delivered data analytics and AI automation engagements for finance and operations teams since 2020, serving US healthcare systems, UK fintech firms, Canadian manufacturing companies, and global SaaS businesses. Rated 5.0 on Clutch, the team designs automation architectures that are audit-ready and compliance-aware from the first workflow - built by practitioners who have managed live automation in regulated financial environments.

If your finance team is ready to move from manual processes to a governed AI automation roadmap, explore our AI automation consulting practice for mid-market finance and healthcare organizations.

Frequently Asked Questions

Bank reconciliation is the recommended first AI automation for most finance teams. It features high transaction volume, structured inputs (ERP exports and bank API feeds), deterministic matching logic, and a clear exception handling pattern. Accounts payable runs closely behind. Both processes are rules-driven and generate immediate audit trails, making them low-risk entry points that typically deliver measurable time savings within the first quarter of deployment.
